Forum Discussion

simcor's avatar
simcor
Tuning in
2 years ago

New installation to block of flats

I live in a block of 18 flats built in 2006.

We can only currently get slow fibre services, the best speed I can get currently is 36mbps as it uses old cabling init the properties and no sign of roll out by open reach to upgrade to full fibre.

Nextfibre were doing works up the main road last year and Virgin now says broadband is available in my area with my postcode.

I have spoken to the management company that look after the buildings and they have stated no issues with having fibre installed, even if it means digging up the tarmac or grassed areas to lay cabling.

Having spoken to an advisor they want me to place an order to arrange a site visit to see if they can install broadband to the the flats, they can't tell me if it is possible without me placing an order and a engineer visit. It seems crazy to me that I have to place an order just to find out if the van do the work, and then if they can't the order will need to be cancelled.

I don't get why they can't do a site visit to the property and canvass the 18 properties for business, they have rolled out the full fibre on the area and seem interested in giving an answers.

As the speeds are still low being a rural area they could have monopoly now over all 18 flats if they so desired. I'm certain most would take up the chance of much higher speeds than we have ever been able to get.

I have lived here for over 16 years and nothing has ever been upgraded in the area in all that time, so was surprised when I found out it was nexfibre doing fibre works. I have just bought my flat in Dec so would welcome better speeds especially for streaming content.

But I also have heard of many horror stories with VM  So I am really undecided to risk going with them.

Any advise greatly appreciated.

17 Replies

  • I should also add I work nights and reading on here shows lots of delays with doing new installs and little or no communication from VM even with install dates being cancelled just before it's due to start on the day to even after the day it was supposed to start. So also I worry about booking time off work while any noisy work is going on and being messed around.

    It is a shame that companies are so readily happily to take your money but provide next to no service or guarantees.

    Like I also said previously it's now in the area yet not one canvasser has been round that I know of trying to get people to switch.

    I suppose like everything the main cable works has been funded by grants to meet government criteria of rolling out faster speeds to more rural areas.

    Tbh I'm rapidly talking myself our of the idea and sticking with Sky who I've been with for the full 16 years, they are far from perfect as I well know but generally it works most of the time and I don't have many issues with sky, in fact I can't remember the last time I lost internet for more than a few minutes or hours at a time.

    I have considered a 4g home hub as well as my phone can often hit much higher speeds than my sky fibre, but again this is limted by so many factors, the least of which I doubt a 5g roll out in my area will be any time sood. I can sometimes connect to 5g on 3 outside the flat but not all the time.

    • simcor's avatar
      simcor
      Tuning in

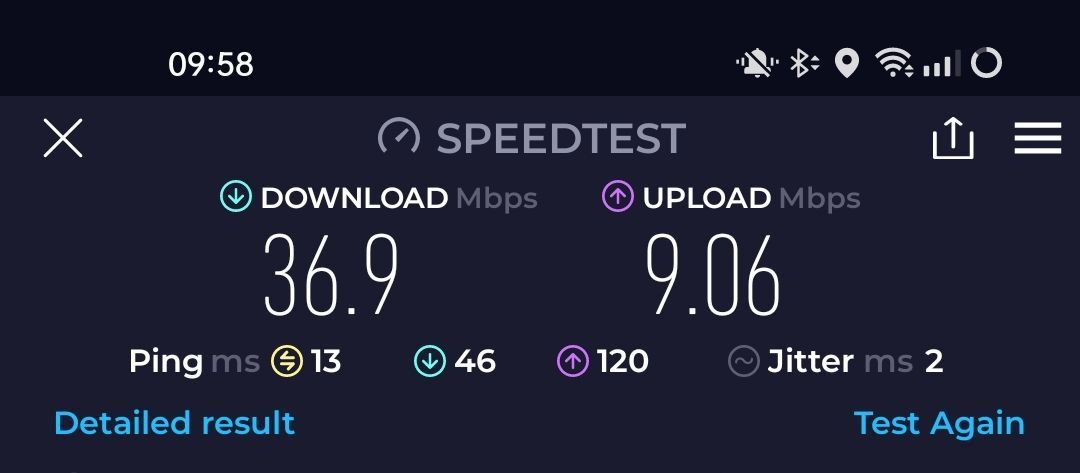

      Sky fibre speed result above.

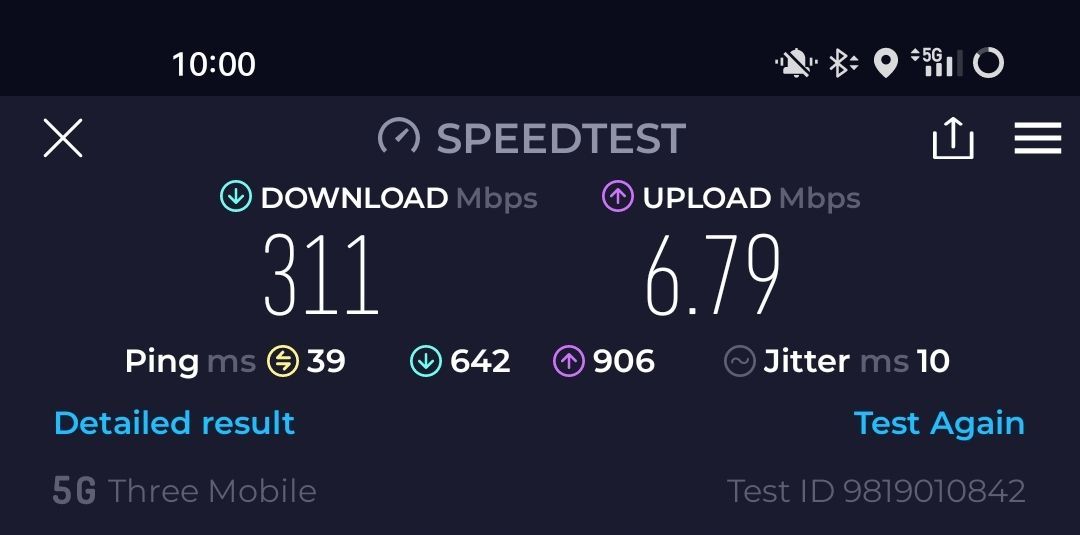

      4G on 3 but also can be as low as 25mbps and very inconsistent as you'd expect from 4G. I've even seen speeds much higher than that at times. But the fluctuation is what really puts me off using a 4G Home hub.

  • jpeg1's avatar
    jpeg1
    Alessandro Volta

    If there is a VM cable passing your block there is just a possibility of getting a connection, otherwise it is unlikely that VM will be interested.  However unless they have plans for a major expansion in the area it is very likely that the local network is running at or near full capacity. They certainly wouldn't be able to connect a large number of flats.

    • simcor's avatar
      simcor
      Tuning in

      Thanks for the reply.

      As I stated though the fibre works were onLY completed a couple of months ago max, sept time IIRC. It is also only this week or says fibre from VM is available, I have been checking every so often and it used to say sorry we are not available in your area.

      So I doubt capacity on the network is an issue yet and for some time as it is a completely new roll out here, never been available before and I think it's the new XGS-PON system, not sure whether that means it will nee underground works or overground as have read it might be over ground via telegraph pole work.

  • jpeg1's avatar
    jpeg1
    Alessandro Volta

    If it's a new XGS-PON system then they will have sufficient capacity. It will most likely be be overhead from the nearest pole, but VM's contractors will need to feed that pole through ducts from their own network. So you do have a chance of a connection but you will be waiting for the local work which will be more than just a cable from the pole.

    • simcor's avatar
      simcor
      Tuning in

      Interesting as not having ground works could well be an interesting proposition. Having checked on Google maps as far as I can tell though there is no overhead words from the nearest pole to either block of flats so all the current infrastructure must be underground ducting. So that possibly raises more questions than it answers 🤔

      • jpeg1's avatar
        jpeg1
        Alessandro Volta

        Yes it will depend on whether that existing Openreach duct and the street ducts leading to it have capacity to carry the VM feed.

  • Roger_Gooner's avatar
    Roger_Gooner
    Alessandro Volta

    What holds up a lot of MDU installations within reach of the VM network is VM not getting permission from the landlord to do the work.

    • simcor's avatar
      simcor
      Tuning in

      I already have permission from the management company to have it done. That would take simple phonecall to them or me to forward the email response from the management company.

  • jpeg1's avatar
    jpeg1
    Alessandro Volta

    When installing in flats, VM will not work outside above the first floor. They will need to run new cables internally.

  • The state agents that run the management company said he would expect them to look at providing the service to all the flats. But again I can't make them do that but at least the start of the infrastructure could be there for other flats dependant on how they would do it, either overground from the nearest telegraph pole or via underground ducting I guess.

  • Having said all of that VM can't even get their own website to work properly. The other day putting my postcode in and flat number it says it's available, now we are back sorry its not available yet but we are on our way. Make your minds up VM.

  •  Guessing here that I've jumped the gun a little.

    After the new fibre runs I assume there will then need to be some new cabinets installed as well?

    Any idea how long after the initial fibre works the cabinet work happens?



    • unisoft's avatar
      unisoft
      Knows their stuff

      simcor wrote:

       Guessing here that I've jumped the gun a little.

      After the new fibre runs I assume there will then need to be some new cabinets installed as well?

      Any idea how long after the initial fibre works the cabinet work happens?




      VM do installs to MDU. It's just whether they want to or not. I lived on a year 2000 estate of new flats. VM came and put all the green cabinets in the estate and cabled internally to the apparatus room. From there, EXISTING cable was used that was already present for Aerial and one Sky Satellite connection to each flat. The flat occupant ordered VM as normal, and the engineer would get the source to the applicable connection by changing feeds in the apparatus room. You couldn't have Sky and VM - it was one or the other due to the fact they were using existing cable. There was a high take-up as only alternative even by 2007 was BT's ADSL and this was East London!

      Outside the private estate, was the relic of the CATV analogue network which they didn't bother upgrading to digital and people couldn't order. Then there was our island, all singing and dancing with new cabinets etc. It took them around 2 months to do.

  • Sorry it has taken me ages to update this. I did order the broadband finally.

    The day after the order the contractor or VM had blown the cable through the existing infrastructure ducting to the 2 blocks of flats on my side.

    Install day a very nice woman came to do the internal work, I explained to her I wanted the router in my front room and how the cable install would go inside the communal hallway. She was amazingly helpful and did the work as tidy as possible and was done in next to no time really.

    So currently I cant fault the order and install process. Not had any issues as yet.

    Speed is excellent and much better than I used to get from sky fibre (not full fibre).

    So as it stands I am so far a very happy customer.

  • I get the following when running the check on my broadband.

    1

    The temperature of your Hub 5x is normal.

    2

    Your broadband connection is working.

    3

    Gateway IPv4 address is valid.

    4

    Gateway IPv6 address is not valid.

    5

    Your broadband connection is ready.

    6

    There is no telephone service.

    7

    There may be devices in your wired network which might be limiting your in-home connectivity.

    8

    The device has low signal strength, please move it closer to Hub 5x.

    9

    Please place your WiFi device near the Hub 5x.

    Any idea why its my PC connected to the router via ethernet cable not wifi.
